PPAP is a production-readiness submission that ties APQP outputs to objective manufacturing evidence rather than a stack of paperwork for its own sake. A complete package covers design records, DFMEA, PFMEA and control plan, measurement system analysis, dimensional and material test results, initial process studies, and a signed Part Submission Warrant. The submission level a customer assigns and any customer-specific requirements decide what gets transmitted, but the underlying evidence is prepared regardless of level.


TL;DR:

  • The PPAP package must include design records, PFMEA, control plan, measurement system analysis, test results, and a signed Part Submission Warrant, with the level dictating what is transmitted.
  • Submission levels range from Level 1, which includes only the Part Submission Warrant, to Level 5, involving on-site review with complete data and samples.
  • Preparing a PPAP involves confirming the request, freezing the design, validating gauges, running representative production, and compiling all supporting documents before submission.
  • Many rejections occur due to incomplete PSWs, mismatched operation numbers, uncalibrated gauges, or missing subcontractor PPAPs, which can be prevented by thorough pre-checks.
  • Production evidence must come from actual manufacturing conditions, using production tooling and trained operators, especially for run-at-rate studies, to ensure parts are truly repeatable.

WJ Prototypes
Prepare Representative PPAP Parts
WJ Prototypes supports automotive teams with precision prototyping and low-volume manufacturing for production-ready development.
Explore manufacturing services

Table of Contents

1. The 18 PPAP elements and what each one proves

Reviewers do not read PPAP elements as a checklist of files. Each element answers a specific question about whether the part and its process are ready for volume production, and preparing them in that order saves rework later.

According to NASA’s PPAP tutorial, a complete automotive PPAP addresses 18 elements, and prototype-made parts do not substitute for production-run evidence when a reviewer checks these items.

  • Design records and authorized engineering-change documents: the current print or model plus proof that any change was formally approved before parts were made.
  • Customer engineering approval: required only when the customer’s contract calls for a pre-production trial sign-off.
  • DFMEA, process flow diagram, PFMEA, and control plan: a linked chain showing design risks, the sequence of operations, process risks, and the controls that manage them.
  • Measurement system analysis (MSA): evidence that the gauges used to check the part are accurate and repeatable enough to trust the data.
  • Dimensional results and material or performance test results: measured values against print requirements, plus lab results for material specs, coatings or functional tests.
  • Initial process studies: capability data (Cp/Cpk or Pp/Ppk) for characteristics the customer flags as critical.
  • Qualified laboratory documentation, appearance approval report (AAR) where applicable, sample production parts, master sample, and checking aids: physical and administrative proof that the parts and tools used to verify them are sound.
  • Customer-specific requirements and the Part Submission Warrant: any extra template or data the customer mandates, closed out by the signed declaration that ties everything together.

2. PPAP submission levels (1 to 5) and what each level means

Submission level controls what gets sent to the customer, not how much evidence gets prepared. A supplier assigned Level 1 still needs the underlying data on file; the level only decides what is transmitted for review.

According to Wikipedia’s summary of PPAP levels, the five generally accepted levels are:

  1. Level 1: Part Submission Warrant only, submitted to the customer.
  2. Level 2: PSW with product samples and limited supporting data.
  3. Level 3: PSW, samples, and complete data, the most common default for production parts.
  4. Level 4: PSW plus whatever additional requirements the customer defines in the purchase order or program documents.
  5. Level 5: PSW, samples, and complete data, but the data is reviewed at the supplier’s facility rather than shipped out.

Customers typically request Level 4 when a program has unusual risk or a nonstandard template, and Level 5 when they prefer an on-site audit over a paper trail.

3. How to prepare a PPAP package from request to submission

A PPAP submission moves faster when the steps happen in a fixed order rather than being assembled backward from a deadline. The Kaizen practitioner guidance on PPAP frames the process as a production-readiness contract, and that framing shapes the workflow below.

  1. Confirm the request: verify the customer’s required part revision, submission level, and any customer-specific format.
  2. Freeze the design: lock the drawing and map its requirements into the process flow diagram, PFMEA, and control plan.
  3. Validate the gauges: run measurement system analysis before collecting any dimensional data that will go into the package.
  4. Run representative production: build parts at production tooling, rate, and quoted conditions, then collect dimensional, material, and performance results.
  5. Assemble and sign: compile the documents, attach samples and checking aids, sign the PSW, and submit through the required customer portal.

Pro Tip: Resolve the customer’s approval status before the first production shipment ships, not after.

4. What reviewers check in the PSW, control plan, PFMEA, MSA, and results

A rejected PPAP is rarely rejected for a single missing document. It is usually rejected because the pieces do not agree with each other or because a required field was left blank.

  • PSW completeness: every field filled (use “N/A” rather than leaving a field blank), signed by an authorized representative, and matching the part revision on the design record. AIAG’s PPAP-4 errata standardizes the PSW language affirming that submitted parts represent actual production.
  • Control plan and PFMEA linkage: operation numbers must match across the process flow, PFMEA, and control plan, with critical characteristics traceable through all three.
  • PFMEA presentation: when a customer restricts full FMEA disclosure, a cover page confirming completion and top risk priority numbers can stand in while the full document stays available for on-site review.
  • MSA minima: a gauge repeatability and reproducibility study typically uses at least 10 parts, 2 operators, and 3 trials, backed by current calibration records for the gauge.
  • Dimensional results: ballooned prints matched to a numbered results table, sampled per cavity on multi-cavity tools, with clear pass or fail marks against print tolerance.

5. What counts as production evidence in a run-at-rate study

A run-at-rate demonstration has to use production tooling, the quoted cycle rate, trained operators, and production-grade materials, not a prototype cell running at a slower pace.

A common OEM benchmark cites a significant production run of several hundred pieces unless the customer specifies otherwise, according to NASA’s PPAP tutorial, which also notes that capability should be reported as Cp/Cpk or Pp/Ppk with the calculation basis and supporting data included so a reviewer can check the math. When a full run is impractical for a low-volume part, suppliers can negotiate a documented representative run with the customer’s written agreement rather than skipping process evidence altogether.

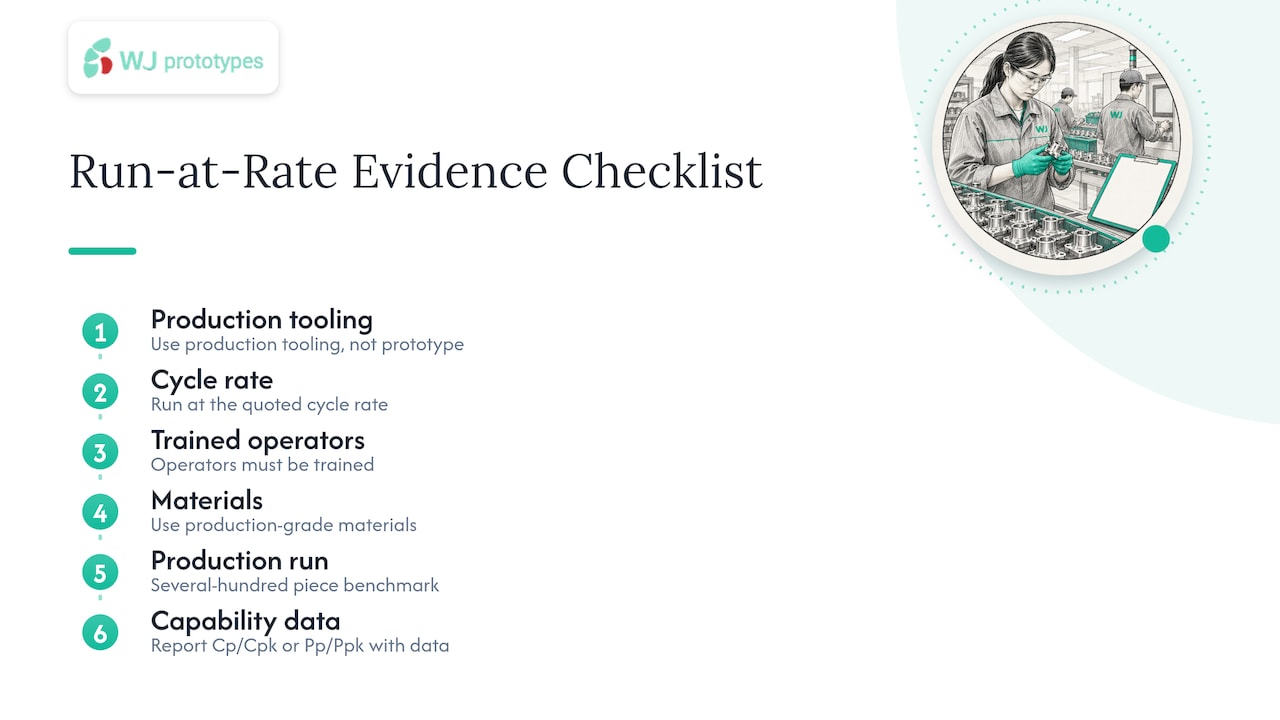

Run-at-rate evidence requirements for PPAP

6. Customer-specific requirements and the checklist traps that cause rejections

OEM supplier manuals rarely stick to the AIAG template word for word. Many set Level 3 as their working default, demand a specific spreadsheet or portal format, and spell out per-element expectations down to how per-cavity measurements should be sampled.

  • Traps to watch for: blank PSW fields, an outdated template, unit or language mismatches between the print and the results, and a missing PPAP from a subcontractor whose part feeds the assembly.
  • Alignment habit: read the purchase order’s PPAP instructions before starting, not after the parts are already made.
  • Traceability habit: keep a running submission checklist tied to the customer’s own portal requirements so nothing gets assembled from memory.

7. Reviewer red flags and a pre-submission checklist

Most rejected packages share the same handful of problems: prototype-tooled parts presented as production evidence, an incompletely signed PSW, operation numbers that do not match between the PFMEA and control plan, unqualified or uncalibrated gauges, and a missing link to a subcontractor’s own PPAP.

  • Ten-minute check: confirm every PSW field is filled, op numbers match across documents, and gauge calibration dates are current.
  • Recovery steps: document the corrective action, ask the customer about an interim approval if production cannot wait, then resubmit with the fix noted.

Pro Tip: Run the pre-submission checklist against the actual signed documents, not the templates, since a template can look right while the signed copy still has a gap.

PPAP as proof of repeatable production, not a paperwork exercise

The point of PPAP is to prove a part can be made the same way, at rate, every time, not to produce a thick binder. Representative production evidence heads off disruptions that a rushed prototype-based submission would only postpone.

— Nas

Producing representative parts and checking aids for a PPAP submission

WJ Prototypes supports the physical side of a PPAP package: sample production parts, master samples, and checking aids made through CNC machining, injection molding, or DMLS, matched to the process a customer expects to see at run-at-rate. This supplier offers ISO certification and quotes projects online with no minimum order quantity, which suits the low-volume runs a PPAP program often needs. Get a project scoped through WJ Prototypes’ instant quote.
